What AI Agent Tasks Actually Cost Developers

7 min read Engineering Agents

Real task data shows why agent cost, active time, review cycles, and developer attention need separate measurements.

A coding agent can return a clean-looking patch in minutes. The developer still has to inspect the diff, run the repository checks, exercise the changed behavior, and confirm that the implementation matches the request. A missed edge case or repository convention sends the task through another implementation pass.

Response time captures only the first patch. Engineering cost includes every run, the model used, failed checks, review comments, corrections, and the developer time required to accept the change.

We examined an anonymized, platform-wide 30-day window from August 6 through September 4, 2026. It contained 534 tasks with active execution time, 533 tasks with recorded cost, and 68 completed tasks across product, engineering, operational, and client work run through Task Machine.

The interface screenshots use fictional examples. The published figures come from the anonymized 30-day dataset.

The dataset suggests five lessons for developers who want agent work to survive tests and review.

1. Measure execution, delivery time, review time, and cost separately

Four measurements describe different constraints in a coding task.

Measurement What it answers Pair it with
Active agent time How long qualifying runs occupied execution capacity Worker availability and queue length
Elapsed delivery time How long the task remained open across work and pauses Blockers and pending decisions
Developer review time How much briefing, testing, and review a person supplied Change risk and task type
Recorded cost How much task-attributed model usage accumulated Model selection and accepted outcome

The average task recorded 1 hour 43 minutes of active agent time and $21.43 in cost.

Average active agent time

1h 43m

Average recorded cost

$21.43

Tasks with active time

534

The dataset contains no developer-review timer. Coding tasks vary too much for the general 5 to 10 minute guidance to be a responsible developer estimate. A narrow change covered by deterministic tests may need a brief review. UI work, migrations, authorization changes, and architecture decisions can require substantially more.

A Task Machine task keeps execution usage, delivery state, and the accepted result together without treating them as the same measurement.

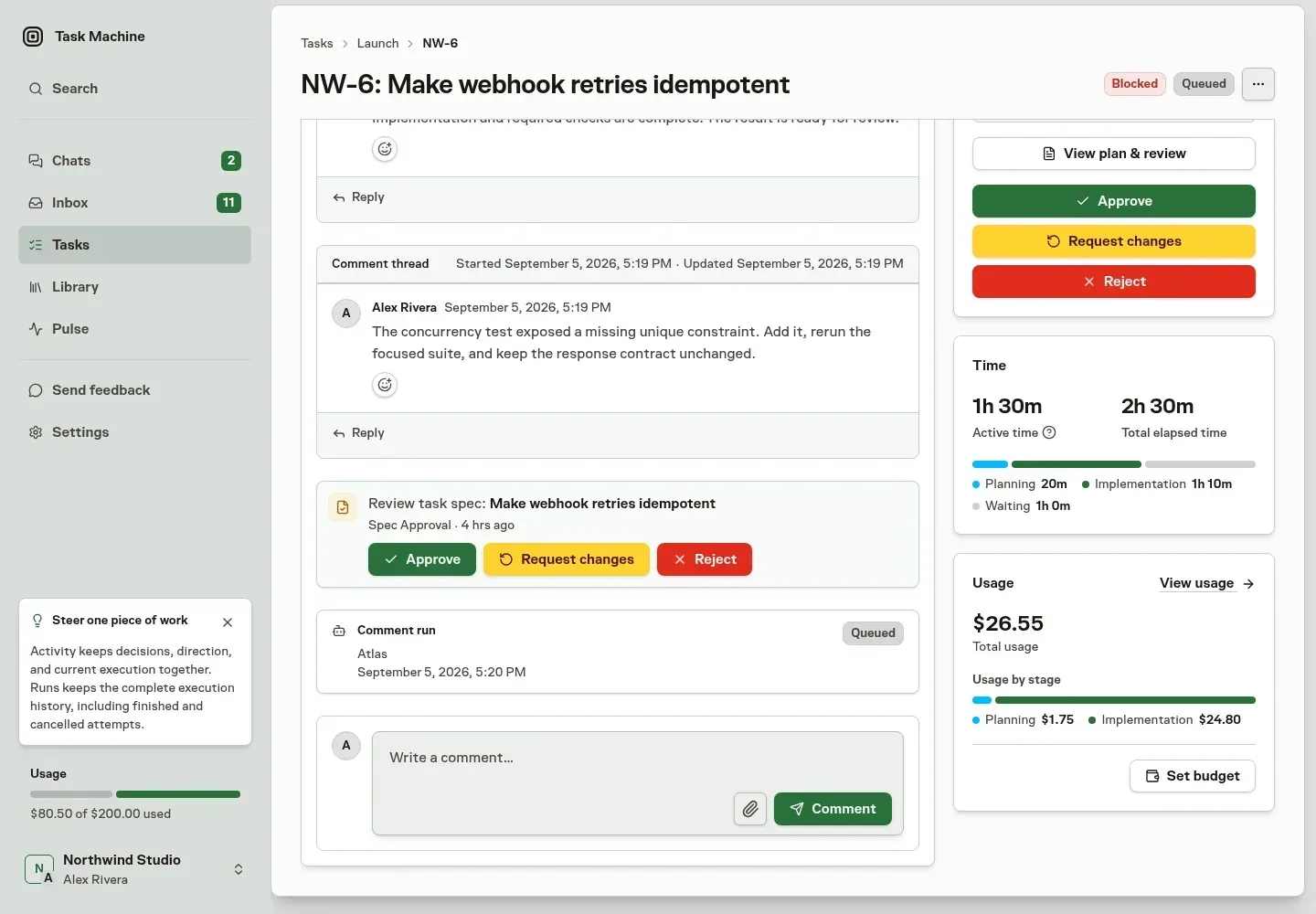

A fictional Task Machine coding task showing concrete review feedback beside active time, total elapsed time, total usage, and usage by stage

The task detail keeps review, duration, and spend together without treating them as the same measurement.

Takeaway: For the next ten agent tasks, record developer review minutes beside active agent time and cost. Group the results by task type before setting a review-time expectation.

2. Keep implementation and requested corrections in one task

A coding task can move through planning, implementation, review, correction, and follow-up. Looking only at the final successful run removes the history that explains its cost.

Recorded cost by execution stage

Share of recorded task cost

100%

Planning 6.1% Implementation 43.0% Review 7.3% Rework 40.5% Follow-up 3.2%

Rework means the agent continued after review requested a change. It can include fixing a missed requirement, applying a developer comment, repairing an integration, or refining an implementation after the first patch exposed a tradeoff. The 40.5% figure measures cost share only. Task failure rate requires a separate count.

Review-driven changes are expected in substantial engineering work. Repeated corrections for the same repository rule or acceptance criterion point to missing setup that should be fixed before the next similar task. Task comments and mentions keep each requested change beside the run it affected, so the next implementation pass starts with the reason intact.

Takeaway: When the same review comment appears twice, add that requirement to the repository instructions, task template, or automated checks before assigning the next similar change.

3. Choose checks from the risk of the change

A single review process fits poorly across backend refactors, interface changes, migrations, and authorization work. Start with automated checks, then add runtime proof and human review where the risk requires them.

Change type Required proof before review Human judgment still needed
Small backend refactor Format, compile, focused tests, scoped diff Whether the change stayed within scope
Permission change Success and denial tests for every affected role Whether the intended access boundary is correct
Rendered interface Rendering tests and screenshots of changed states Whether the experience is clear and visually acceptable
Database change Migration review and tests against the migrated schema Whether rollout and data ownership are correct
External action Dry run or exact action preview Whether the action should happen now

A green test suite proves only the behavior covered by those tests. The task still needs a person when product meaning, risk, or visual quality determines acceptance.

During the agent loop, the Work Spec holds the expected behavior, preserved constraints, required checks, and human review boundary before implementation begins.

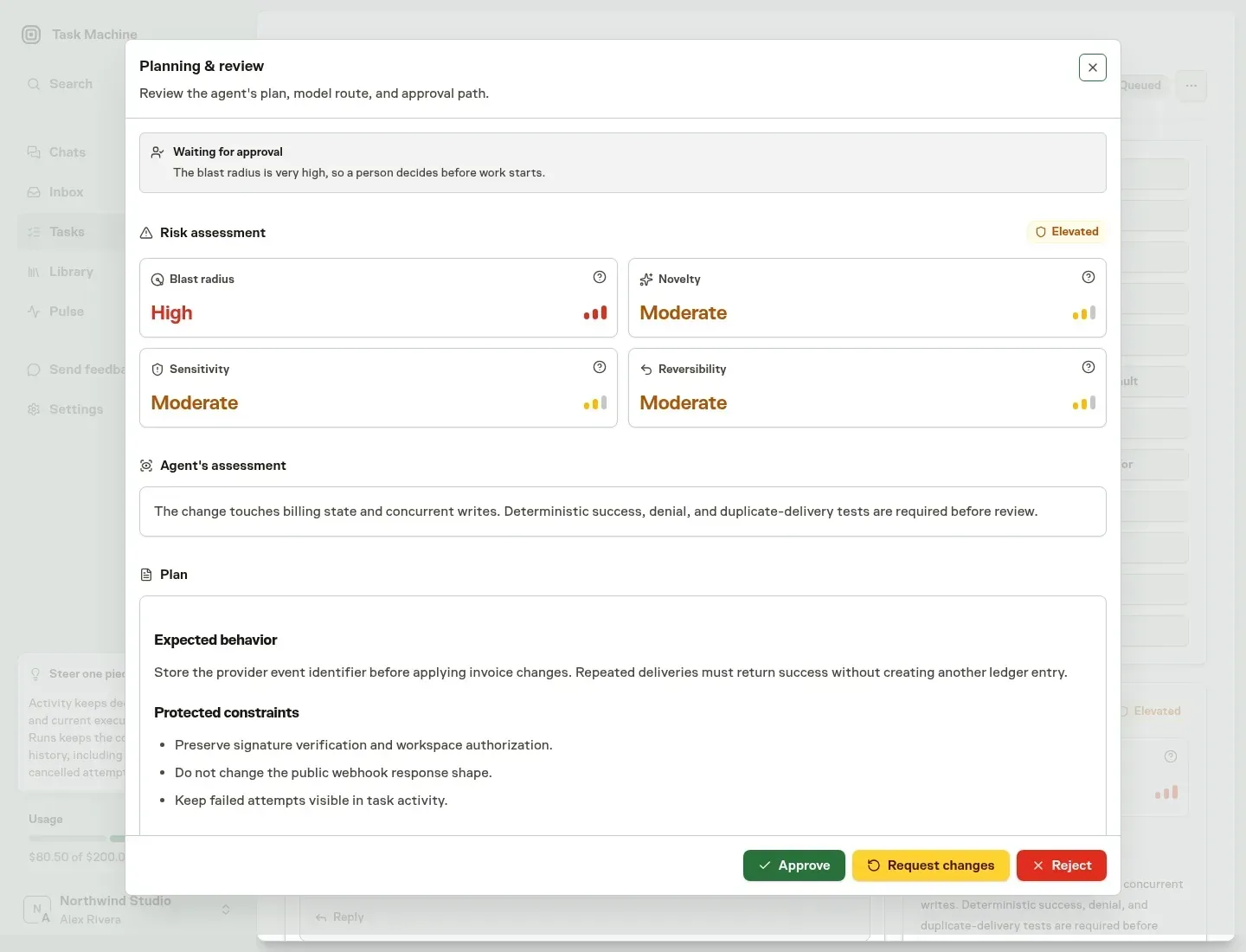

A fictional Task Machine Planning & review modal showing a high blast radius, the four-part risk assessment, the agent's assessment, and the coding plan

The review surface makes task risk visible before a person approves the Work Spec and coding begins.

Takeaway: Before starting a coding task, write the exact commands, runtime evidence, and human decision required for acceptance. Remove any check that cannot change the accept-or-revise decision.

4. Budget by model and leave room for expensive tasks

The median task cost $0.20, the average was $21.43, the 90th percentile reached $81.42, and the highest task reached $468.04.

Average recorded task cost

Across 533 tasks with recorded cost

$21.43

Median $0.20 Average $21.43 90th percentile $81.42 Highest $468.04

The period included GPT-5.6 Luna, Sol, and Terra. Model choice can materially change the cost of similar token usage. Task complexity, repository exploration, review cycles, and failed attempts add further variation.

A cost cap should create a decision point before it interrupts valid work. Long tasks need a checkpoint where the developer can inspect progress, narrow the scope, switch approach, or authorize the next block of work.

Task Machine budgets set the spend boundary that routes an exception for a person to decide. Model selection remains an explicit input to that budget and the task estimate.

The Task Machine Budgets page showing workspace and agent budgets with their periods, limits, and current spend

A budget turns a cost boundary into a visible checkpoint instead of silently interrupting valid work.

Failed attempts remain part of recorded cost

An unsuccessful run can disappear from active-time reporting while its positive cost remains in the task total. The spend happened even though the run failed to produce the accepted patch. Keeping it exposes expensive failure paths and keeps the budget aligned with the bill.

Takeaway: Set a model and initial budget before execution. Require a developer decision when a task crosses $81, repeats the same failed check, or needs a third implementation pass.

5. Make review requests immediately actionable

Agents asked 237 questions, and people made 395 approval decisions during the reporting period.

Agent questions

237

Approval decisions

395

A developer should receive the exact missing decision, relevant files or output, checks already run, and the action available next. A generic notification forces the developer to reconstruct the task before reviewing it.

The reviewer should return a concrete reason with every requested change. That reason becomes part of the next run and makes repeated objections visible across similar tasks.

For pull requests, the Inbox presents the reported change, exact reviewed head, automated review result, and approve-or-revise actions in the same decision.

A Task Machine pull-request review decision showing the reported change, exact reviewed head, passing pre-review evidence, and approve or reject actions

The review request identifies the exact code version and evidence covered by the developer's decision.

Takeaway: Require every review request to include the changed files, completed checks, remaining uncertainty, and an explicit accept-or-revise decision.

Apply the lessons in the next sprint

Choose one category of coding task and apply the same operating rules for a full sprint:

  1. Record active agent time, developer review time, model, and cost.
  2. Keep the first patch and every requested correction in one task history.
  3. Define required checks from the risk of the change.
  4. Require a developer decision at the cost or retry boundary.
  5. Review recurring comments and update the repository instructions.

Chat remains suitable while the team is still deciding what to build. A task should begin once the expected behavior and acceptance decision are clear.

Inspect the current platform averages and calculation method on Task Machine Pulse, then compare them with the next ten coding tasks in your own repository.
